Documentary trigger gateway

Commissioning of the Final Turbine

A plain-English reconciliation of the planning-permit, endorsed-plan and monitoring obligations that follow from the final-turbine commissioning milestone, together with the presently disclosed date record.

Why this date matters

One milestone, several mandatory pathways

The commissioning of the final turbine is not merely a project-history date. The Planning Permit and endorsed management material use that milestone to start, end or measure a number of administrative obligations. Other endorsed material uses closely related wording such as “commencement of operation”. This page preserves the exact source wording while showing how the requirements fit together.

This page does not determine technical compliance. It identifies the trigger, the requirement, the disclosed documentary record and any question that remains open.

Governing documentary pathway

How the NCTP obtains authority within the permit framework

Planning Permit PL-SP/05/0461 is the authorising document for the Lal Lal Wind Farm. Condition 25 requires a Noise Compliance Testing Plan and provides that, once approved and endorsed by the Minister for Planning, the NCTP forms part of the Planning Permit.

Regulation 131B of the Environment Protection Regulations identifies the authorising document as the source that determines the relevant wind farm noise standard, including any conditions that modify or replace requirements of NZS 6808:2010. Within that statutory framework, the endorsed NCTP derives its authority through the Planning Permit and establishes the project-specific noise-testing pathway.

Planning PermitAuthorising document
Condition 25Requires and incorporates the endorsed NCTP
Regulation 131BRecognises the standard specified by the authorising document
Endorsed NCTPProject-specific monitoring and reporting pathway

The documents do not use one uniform expression. The Planning Permit refers to commissioning of the facility and full operation of the facility, while the endorsed Noise Compliance Testing Plan (NCTP) establishes the project-specific operational noise pathway using commissioning of the last turbine as the trigger for pre-operation requirements, post-construction noise monitoring, compliance testing and reporting. Once endorsed, the NCTP forms part of the Planning Permit under Condition 25 and therefore sits within the same permit framework as Conditions 12 and 17, which also use, or operate by reference to, commissioning of the last turbine. This page preserves those differences in terminology while demonstrating how the operational noise pathway aligns with the same commissioning milestone reflected elsewhere in the Planning Permit, rather than treating the various expressions as automatically synonymous.

At a glance

What follows from the trigger?

Read from left to right: the source identifies the trigger, the trigger starts or ends an obligation, and the later record should show what happened next.

Final turbine commissionedCentral project milestone
Landscaping window closesCondition 12
Bird and bat monitoring runsCondition 17 and endorsed plan
Noise testing stages occurNCTP pathway
Reports are submittedNCTP section 6.0
Reconciliation table

Trigger requirements and the disclosed record

This table identifies the controlling trigger, the required administrative step and the presently disclosed documentary position. The detailed source reconciliation follows below.

SourceExact trigger or timing conceptWhat was requiredPresent documentary position

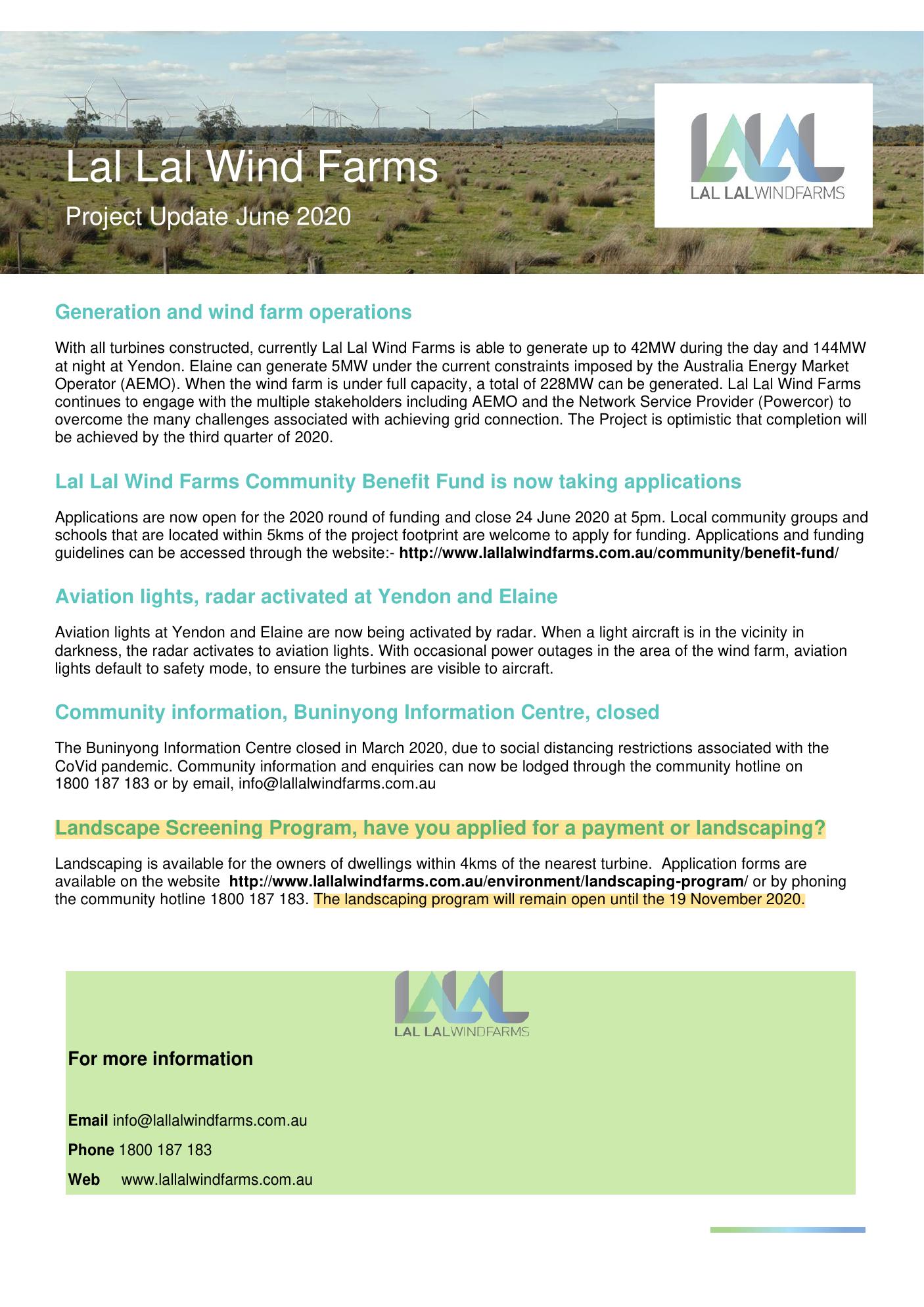

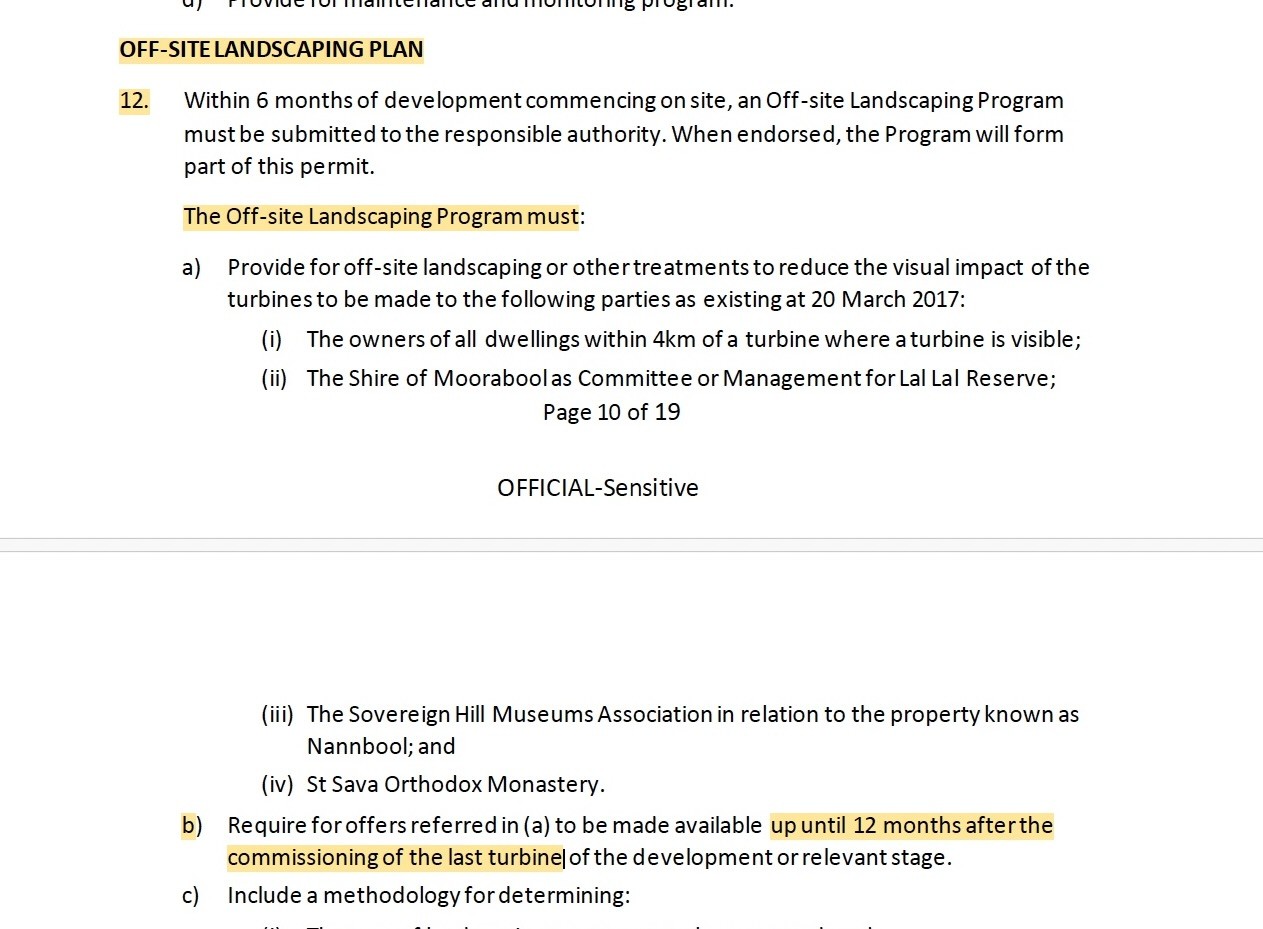

Planning Permit PL-SP/05/0461 — Condition 12Twelve months after commissioning of the last turbineThe off-site landscaping program remained available until the end of that period.The December 2019 CRG minutes and June 2020 Community Bulletin identify closure dates implying a final-turbine commissioning milestone of 18–19 November 2019.

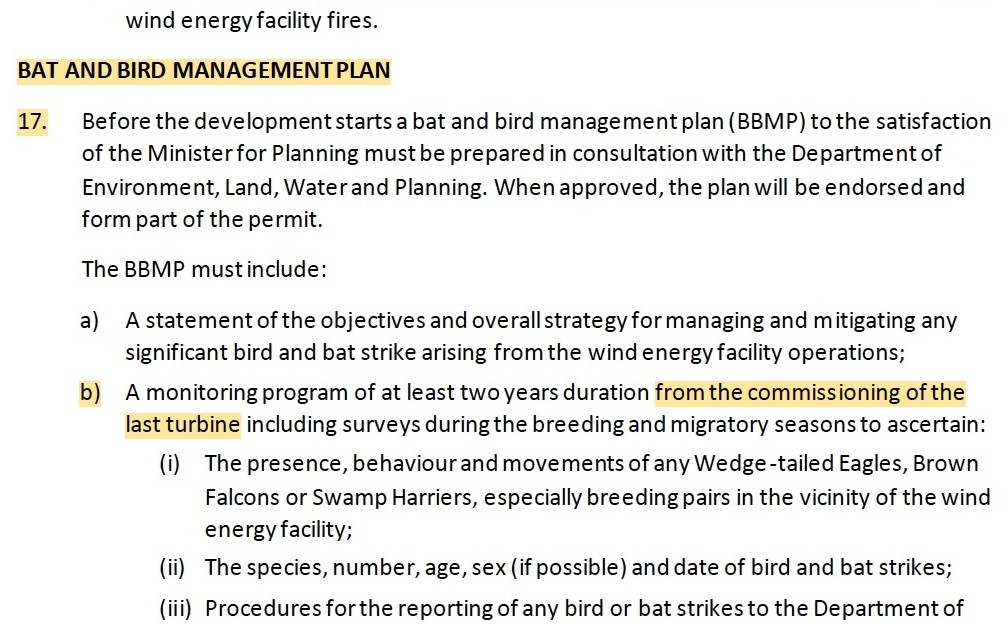

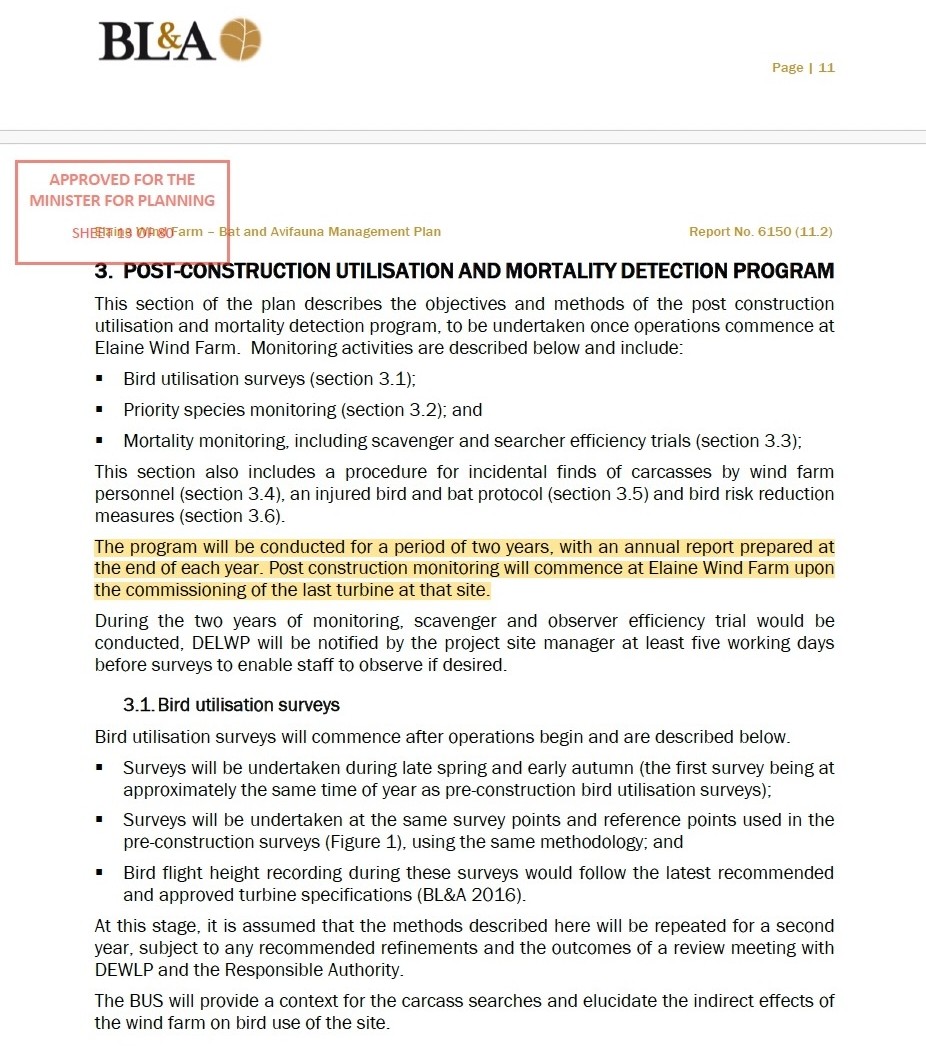

Planning Permit PL-SP/05/0461 — Condition 17Commissioning of the last turbineThe endorsed bat and bird management pathway required monitoring and reporting by reference to the commissioning of the last turbine.The disclosed correspondence records that the second and final annual bird and bat monitoring report was linked to the commissioning of the final turbine on 18 November 2019. The correspondence is preserved as evidence of the commissioning date used in administering that monitoring and reporting pathway.

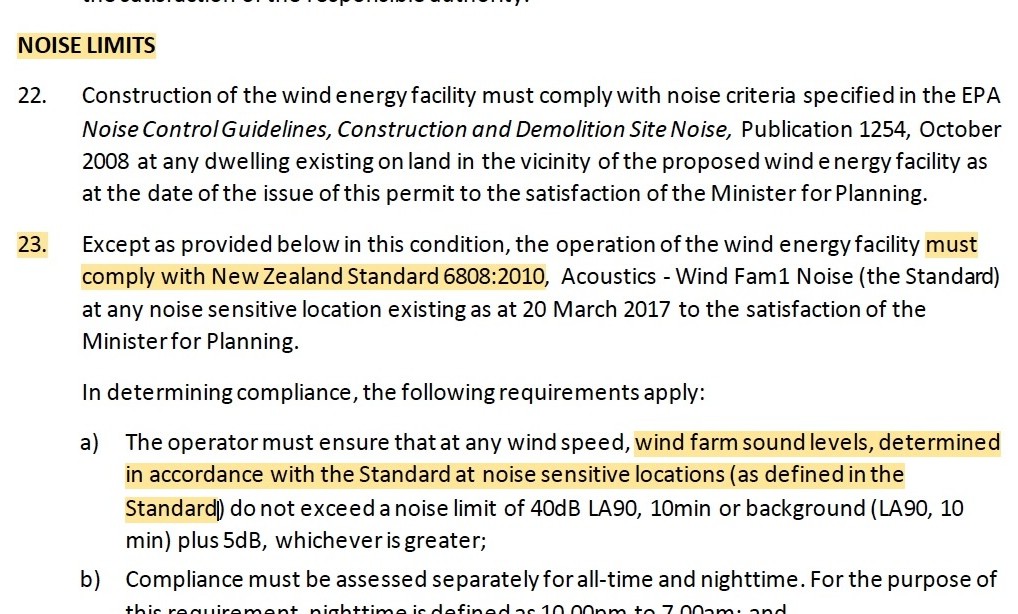

Planning Permit PL-SP/05/0461 — Conditions 23–25Operational noise frameworkThe permit established the operational noise limits and required an endorsed Noise Compliance Testing Plan.The detailed pathway is preserved through the permit, NCTP, Jacobs review, K15aa record and post-construction monitoring reports.

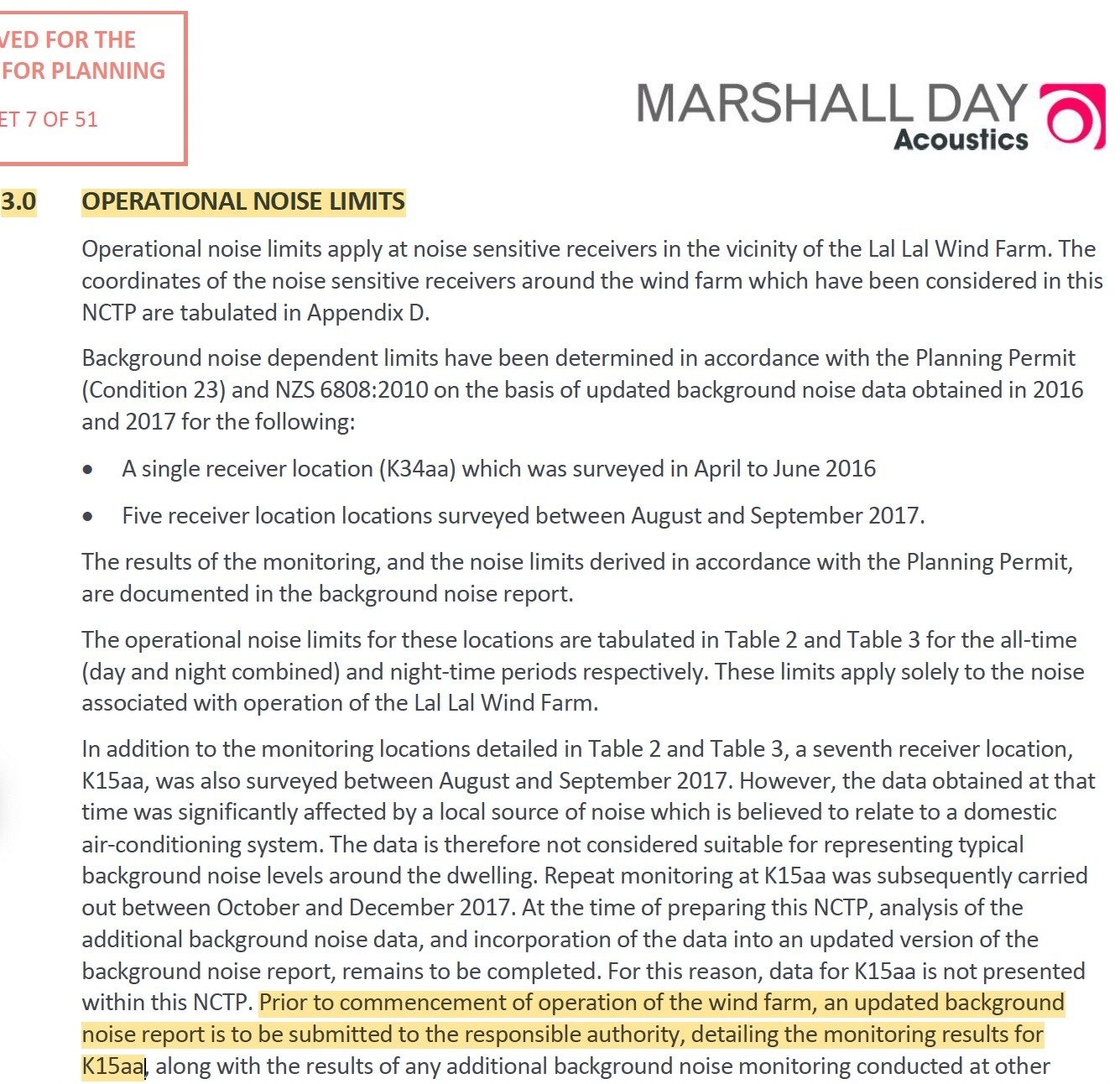

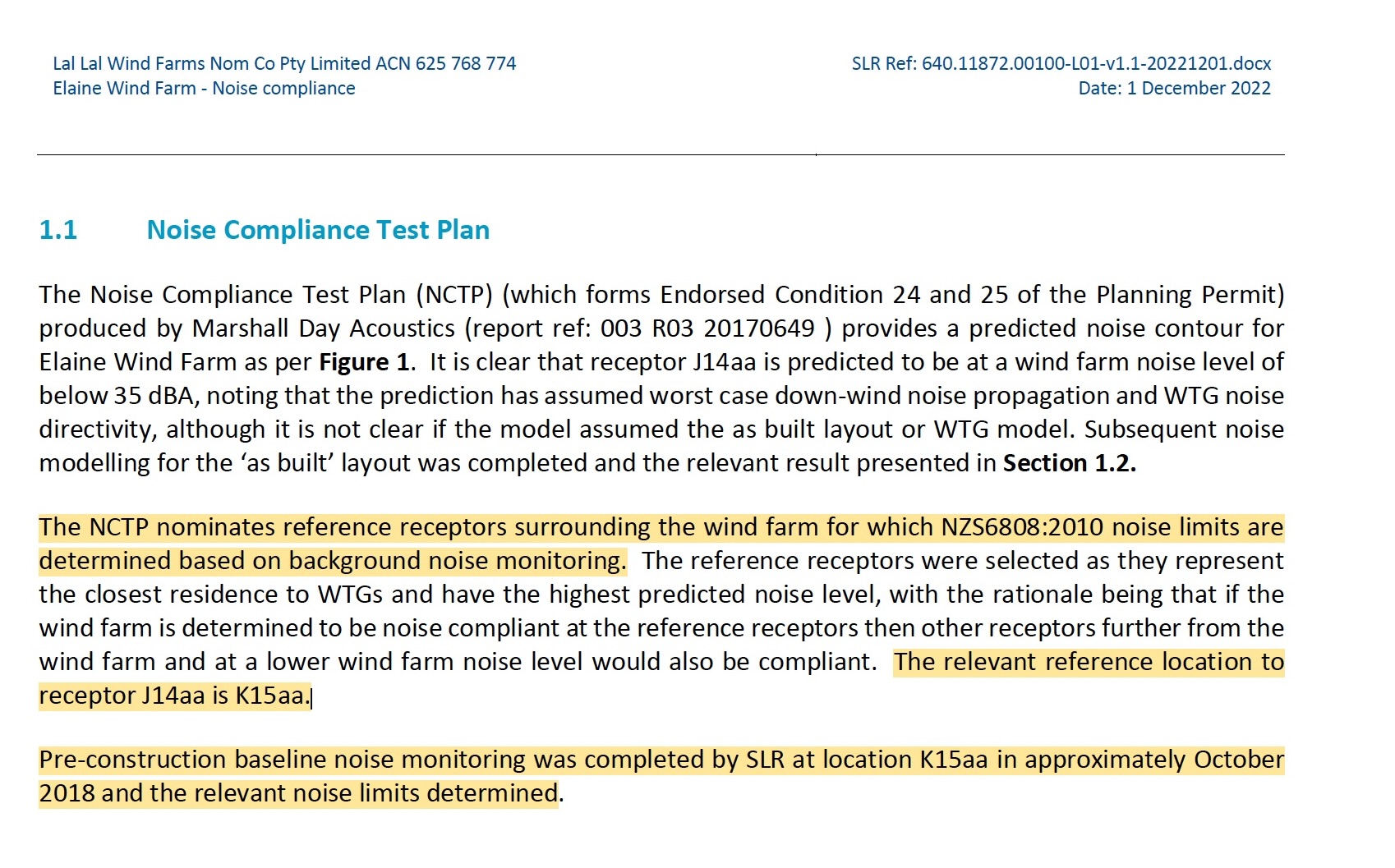

Endorsed NCTP — updated K15aa report“Prior to commencement of operation of the wind farm”An updated background noise report detailing the K15aa monitoring results was to be submitted to the Responsible Authority.The published K15aa report is dated 16 February 2021. The associated electricity-export, turbine-generation and 2019 monitoring chronology is examined below.

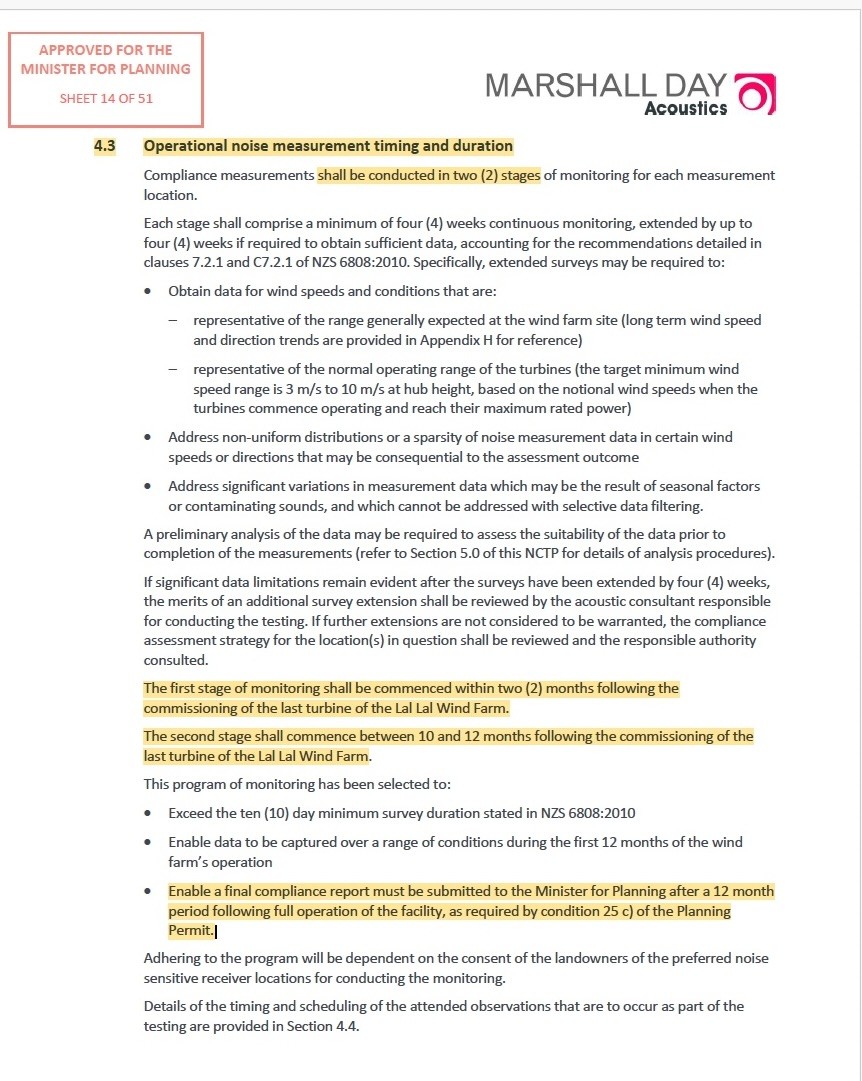

Endorsed NCTP — Stage 1“The first stage of monitoring shall be commenced within two (2) months following the commissioning of the last turbine of the Lal Lal Wind Farm.”Stage 1 operational monitoring was to commence within two months following commissioning of the last turbine.Elaine monitoring was completed on 13 May 2021. Yendon monitoring was completed on 1 August 2022.
Endorsed NCTP — Stage 2“The second stage shall commence between 10 and 12 months following the commissioning of the last turbine of the Lal Lal Wind Farm.”Stage 2 operational monitoring was to commence between 10 and 12 months following commissioning of the last turbine.Elaine Stage 2 monitoring was completed on 1 June 2023. Yendon Stage 2 monitoring was completed on 19 January 2024. The two dates are preserved separately.
Endorsed NCTP — section 6.0Completion of the monitoring undertaken for the relevant compliance stageThe corresponding compliance report was required to be submitted to the Minister for Planning within six weeks after that monitoring was completed.The disclosed monitoring-completion dates may be compared with the dates appearing on the corresponding reports. The actual Ministerial submission dates remain dependent upon the administrative record.

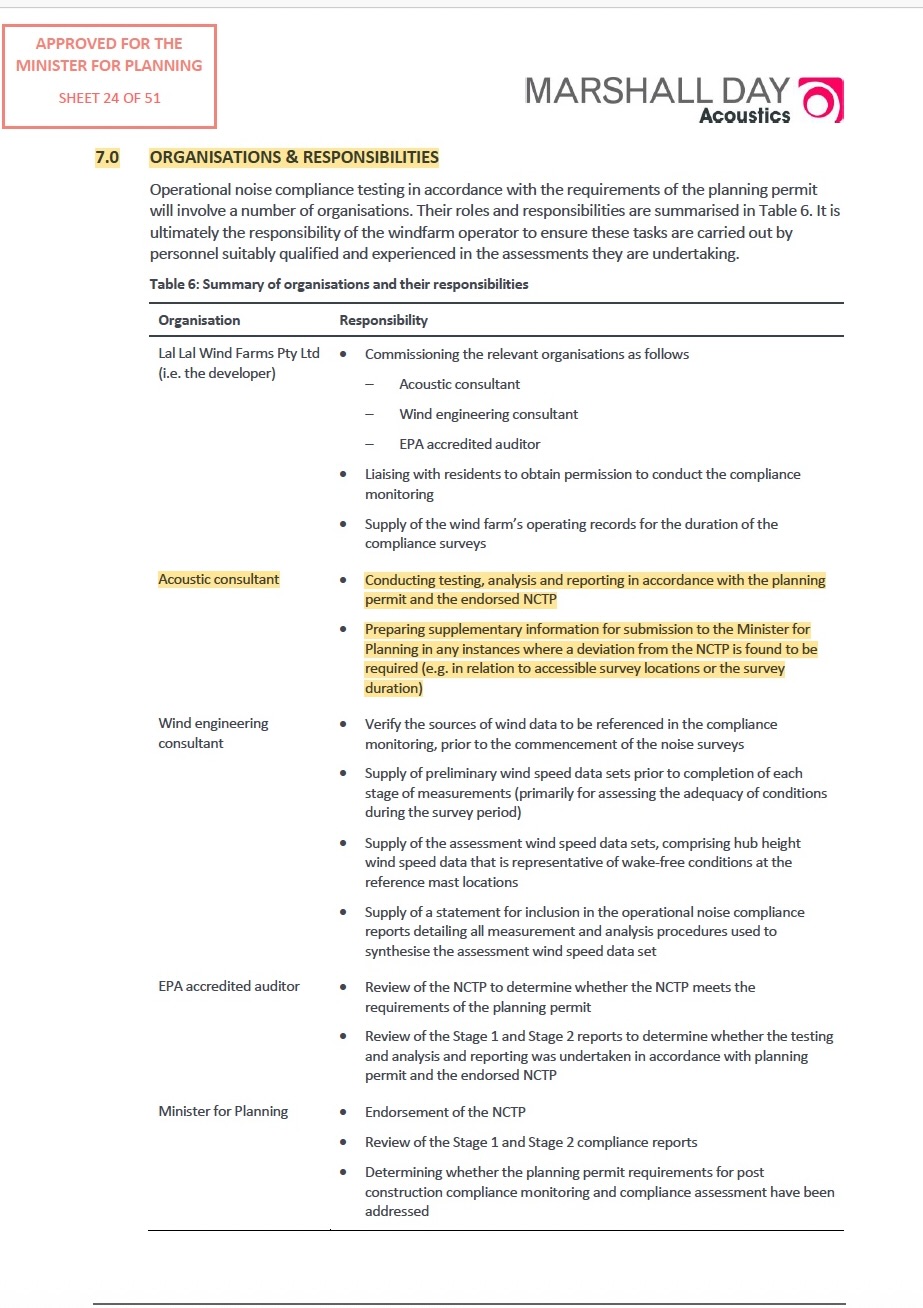

Endorsed NCTP — section 7.0Each step in the endorsed testing and reporting pathwayThe operator, acoustic consultant, wind engineering consultant, Environmental Auditor and Minister had identified responsibilities.The responsibility table assists readers to identify which organisation prepared, reviewed, verified or received each part of the pathway.
Primary documentary exhibits

The permit, endorsed plan and source chronology

Each exhibit identifies its source document in the heading. The image provides a readable extract; the linked source document preserves the complete record.

Planning Permit triggers

Public commissioning chronology

The following contemporaneous public records preserve the developing commissioning chronology from December 2019 through June 2020. The landscaping records identify an implied final-turbine milestone, while the March 2020 minutes record that the post-construction noise monitoring program was delayed because the wind farm was not operating at full capacity.

Other commissioning-linked monitoring record

Other documentary material records how the final-turbine commissioning milestone, and the related concept of commencement of operation, were used in administering monitoring and reporting pathways.

Operational noise framework and the K15aa pathway

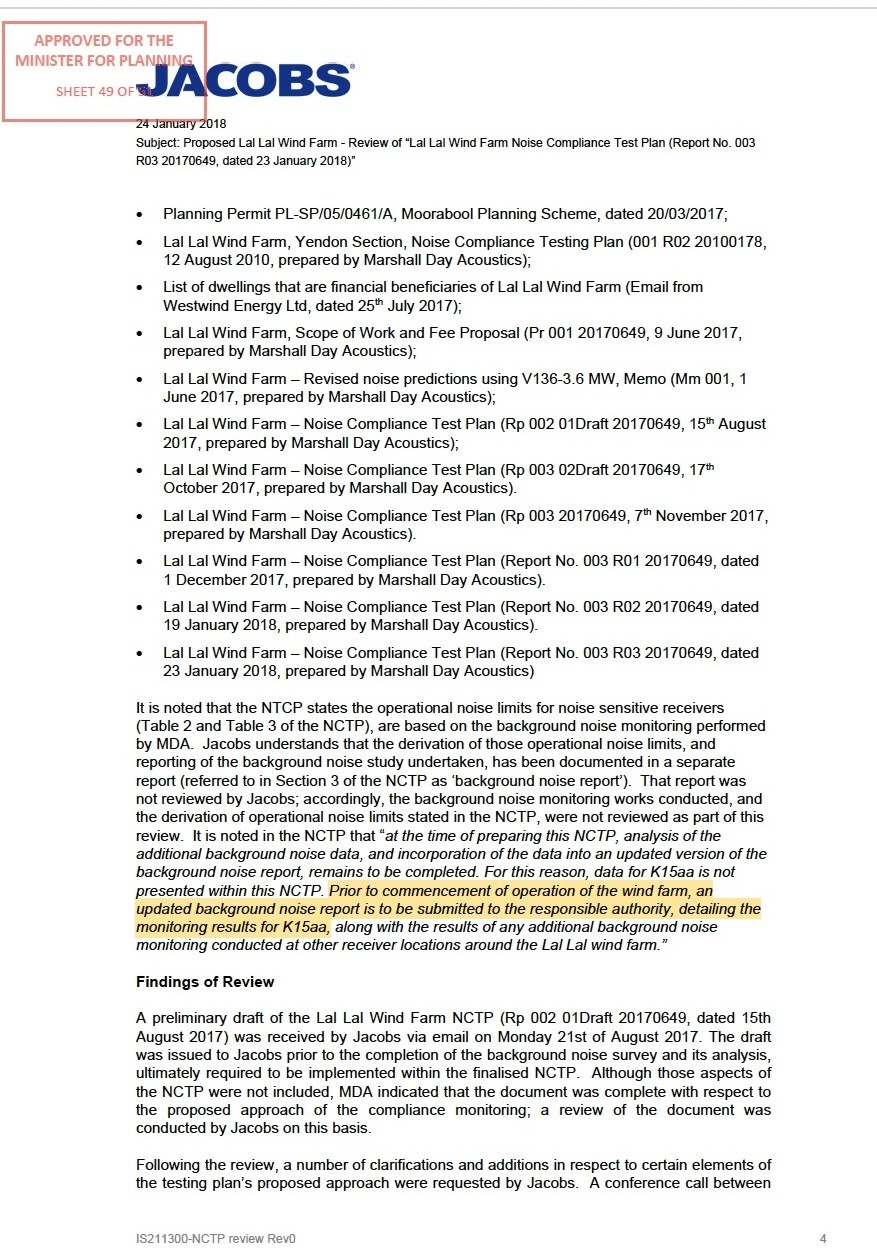

Read in sequence, the endorsed NCTP records the applicable background-noise pathway and pre-operation requirement, the Jacobs review independently records that relationship, and SLR's later correspondence states how it regarded the K15aa baseline as having been established.

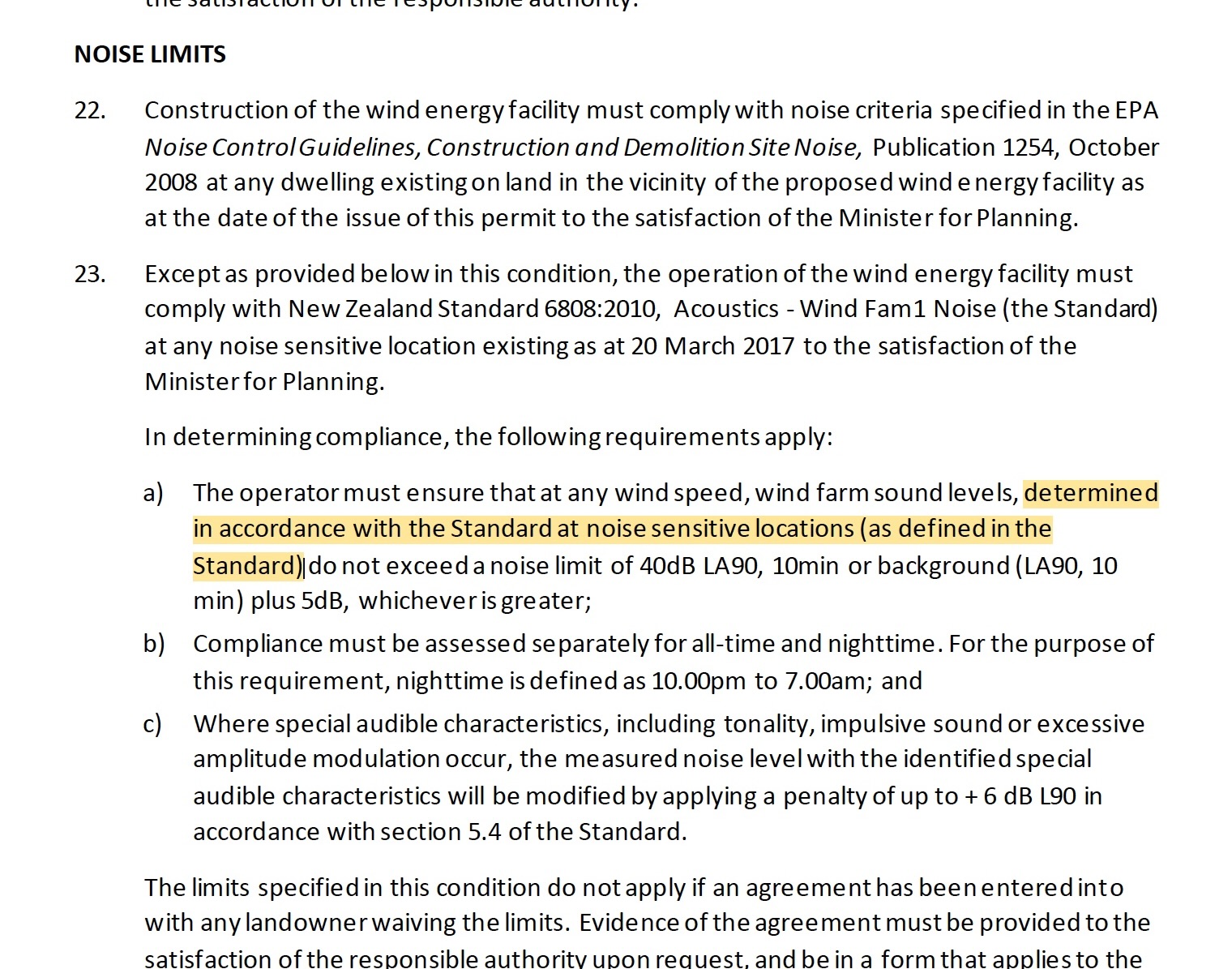

Planning Permit Condition 23

Noise sensitive location — definition incorporated by the permit

Documentary significance: Condition 23 does not use “noise sensitive location” as an undefined project-specific expression. It expressly directs the compliance assessment to the definition in NZS 6808:2010. That definition, in turn, includes points within the notional boundary of buildings containing the specified noise-sensitive spaces. The NCTP, K15aa and later monitoring-location records are therefore read on this website together with the location terminology expressly incorporated by the permit. Whether a particular monitoring position satisfied, represented or departed from that framework is addressed on the NZS 6808, K15aa and Representative Monitoring pages.

Commencement-of-operation record

The documentary record contains separate descriptions of background sound, limited turbine operation during the 2019 K15aa monitoring program and commencement of operation. These records are presented together for documentary reconciliation and are not treated here as determining technical compliance.

NZS 6808:2010 documentary reference

The Appendix H chronology is to be read together with the NZS 6808:2010 definition of background sound:

“Background sound — The A-frequency-weighted L90 centile level measured prior to the installation of any wind turbines in an area.”

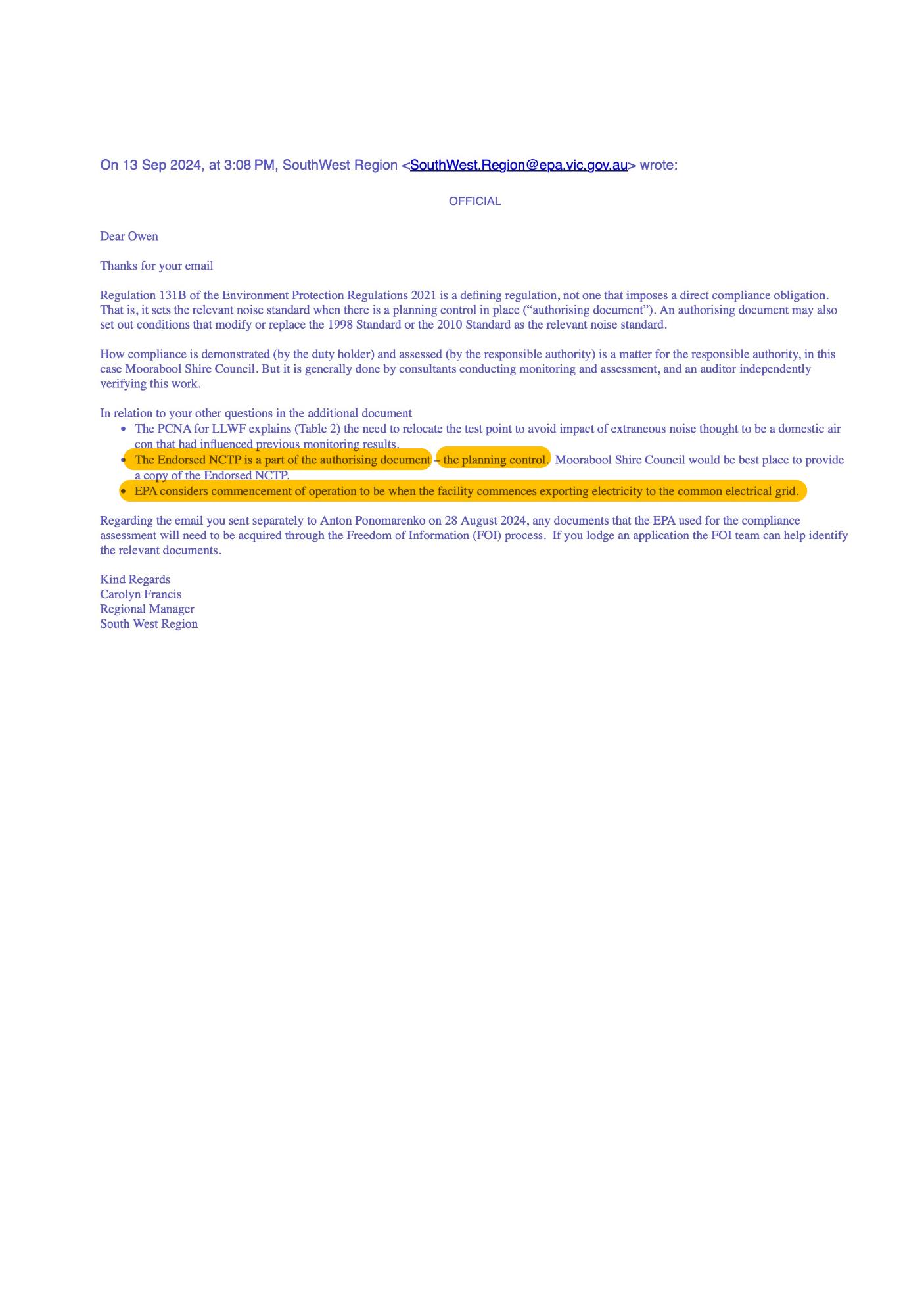

Together, the records preserve three distinct concepts: the Standard's definition of background sound, EPA's administrative position on commencement of operation, and SLR's recorded chronology of turbine operation and generation during the 2019 K15aa monitoring program.

Earlier FOI records — K15aa background report

EPA FOI-100-2025. In the Beneficiary's historical EPA FOI request, the Lal Lal Wind Farm Compliance Baseline Monitoring Report 640.11872-R01 v1.1 dated February 2021 was expressly requested. EPA's decision identified nine responsive documents, but the scheduled documents did not include that foundational K15aa report, and the decision did not separately address whether the report was held or why it was not provided.

DTP FOI CS015467. The Beneficiary also requested the date on which the SLR Lal Lal Wind Farm Compliance Baseline Noise Monitoring Report 640.11872-R01 dated February 2021 was submitted to the Department, Minister or Responsible Authority. In its decision dated 1 October 2024, the Department of Transport and Planning advised that extensive searches located no information relevant to the request and that it appeared no relevant documents had been submitted to the Department.

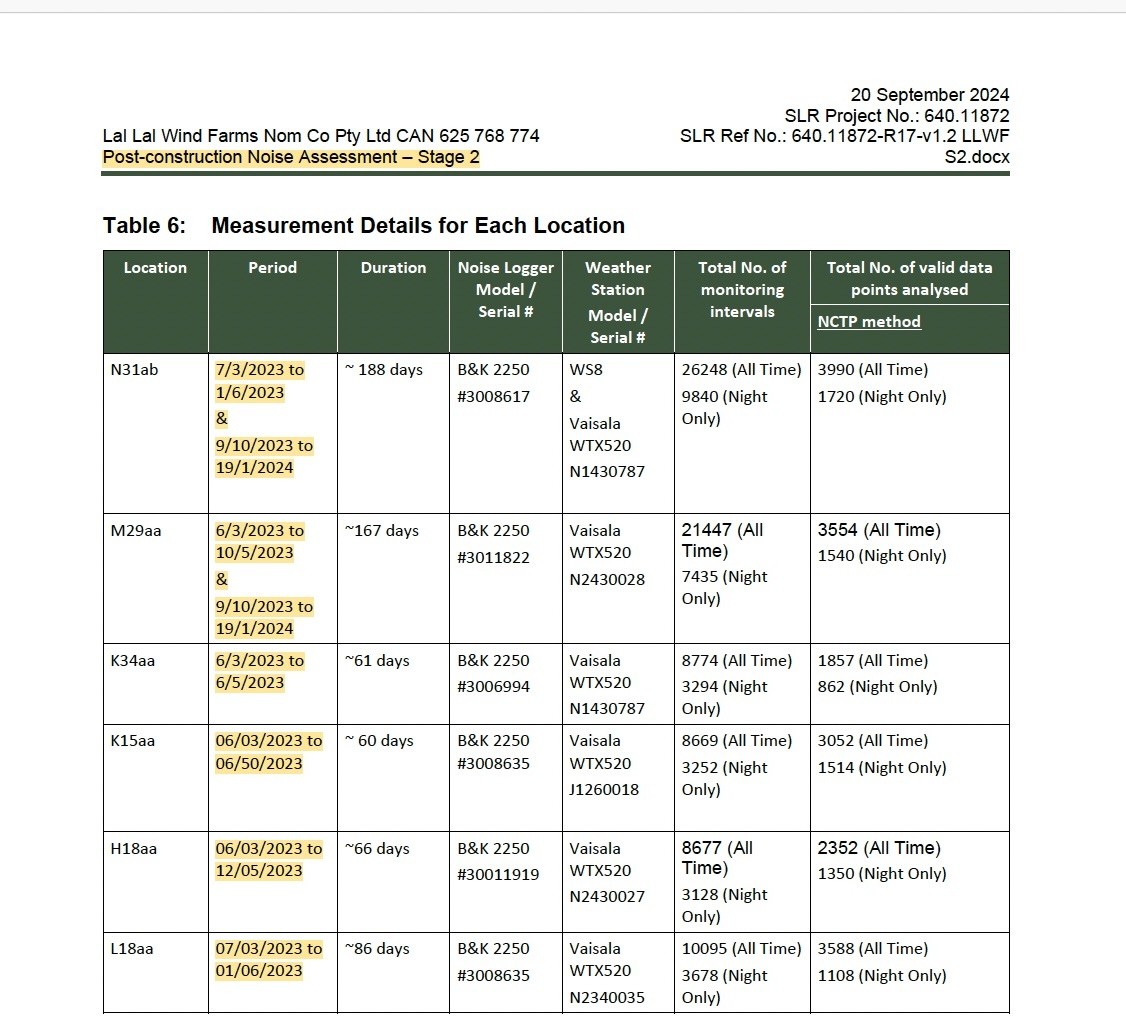

NCTP post-construction monitoring stages

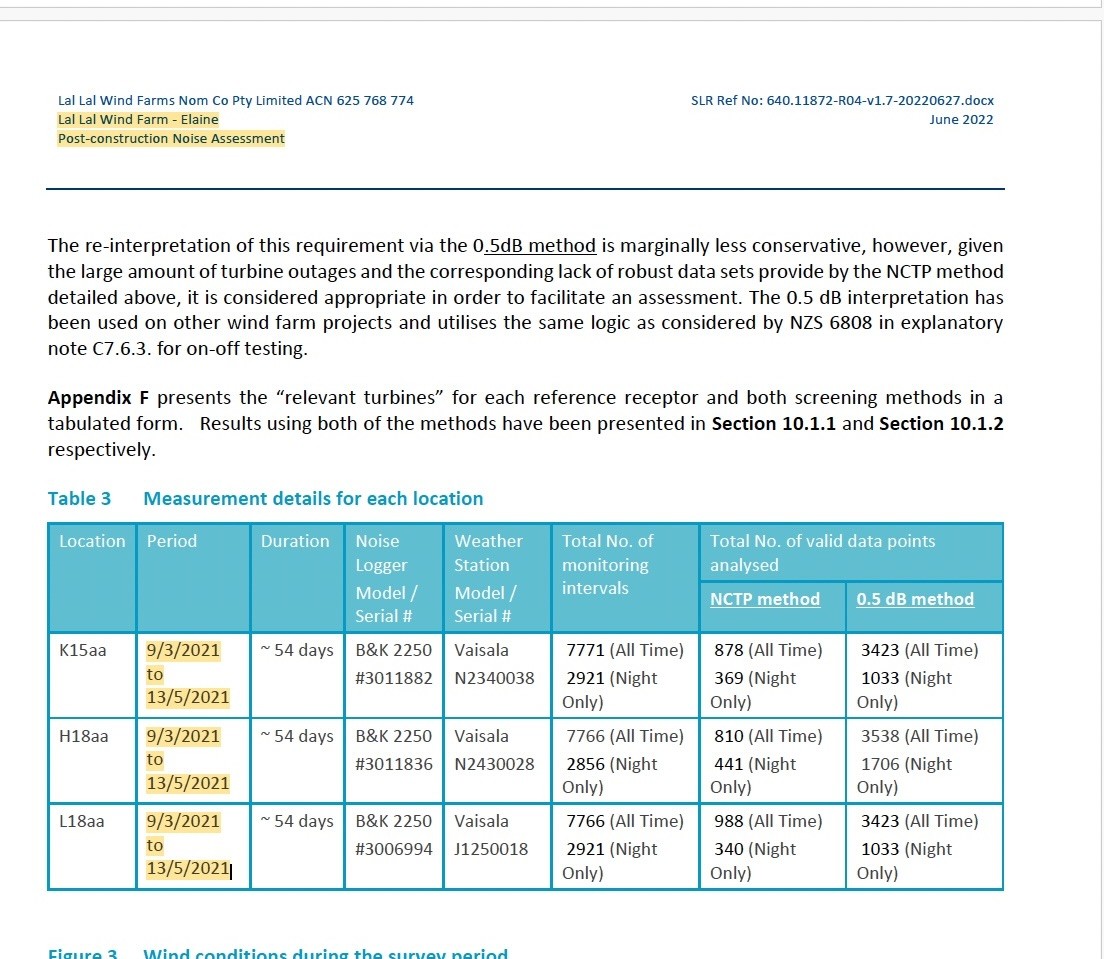

The NCTP uses commissioning of the final turbine as the trigger for both mandatory post-construction monitoring stages. The disclosed Elaine and Yendon completion dates are preserved separately.

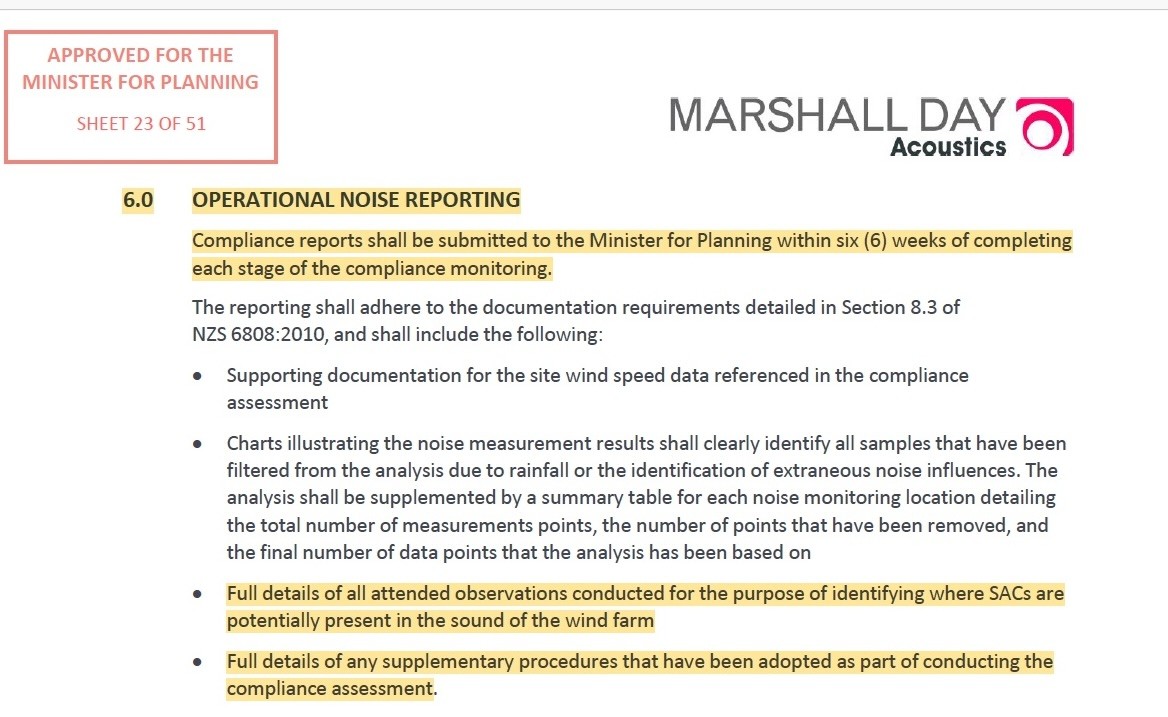

NCTP section 6.0 reporting chronology

Section 6.0 starts the reporting period when the monitoring undertaken for the relevant compliance stage is completed. The corresponding compliance report was required to be submitted to the Minister for Planning within six weeks after that monitoring was completed.

Conflicting commissioning and operational-status record

The disclosed record uses several different dates and project-status expressions: final-turbine commissioning, completion of commissioning, commencement of operation, release to full output, practical completion and later references to ongoing commissioning. The records below are presented together because the endorsed NCTP uses commissioning of the last turbine as a mandatory timing trigger. The page does not assume that these expressions are interchangeable.

Side-by-side reconciliation

Commissioning-related descriptions in the disclosed record

RecordDate or status recordedDocumentary significance

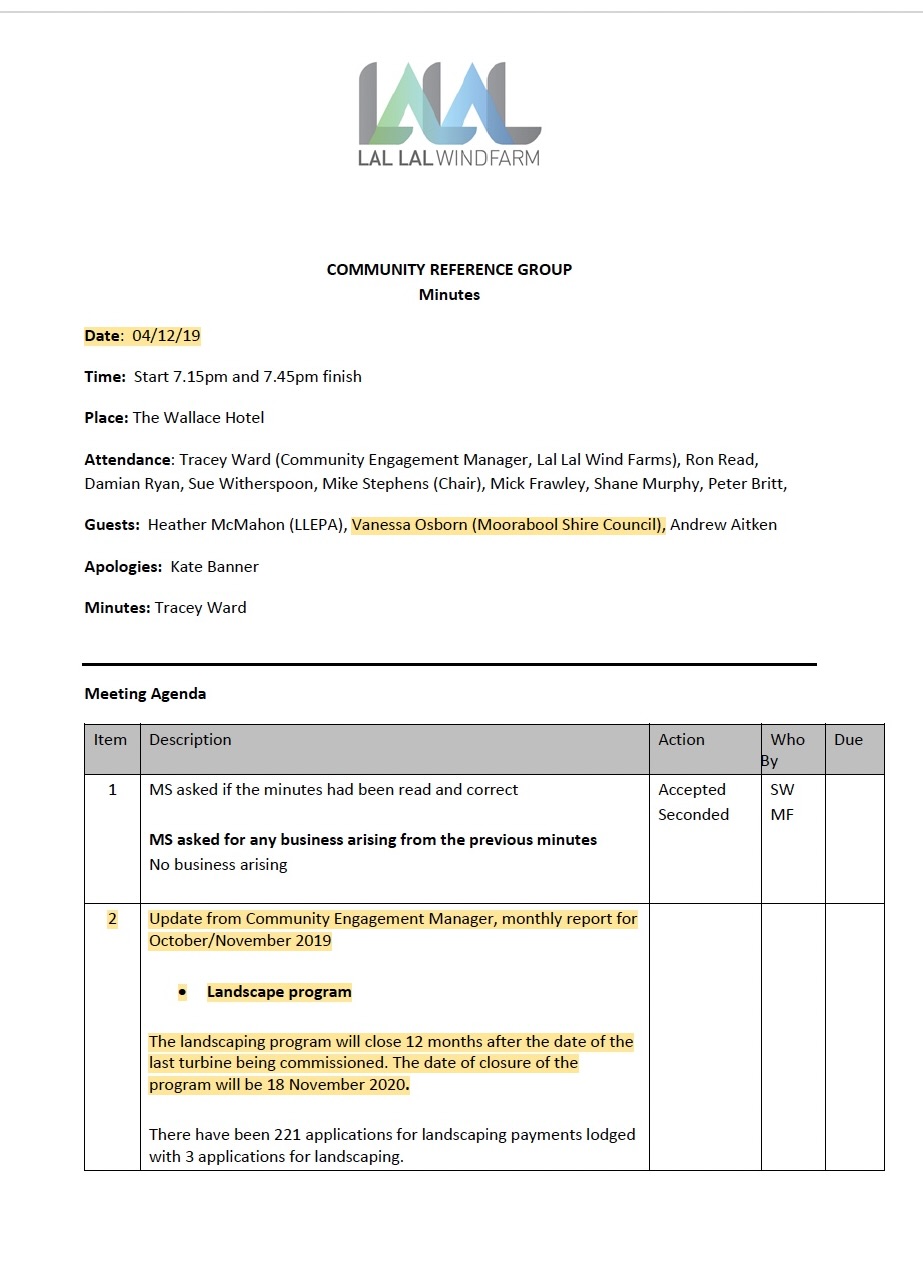

CRG / landscaping record Closure dates imply final-turbine commissioning around 18–19 November 2019. The date is inferred from a permit-linked 12-month landscaping period; no formal commissioning certificate was located in the later Council FOI record.

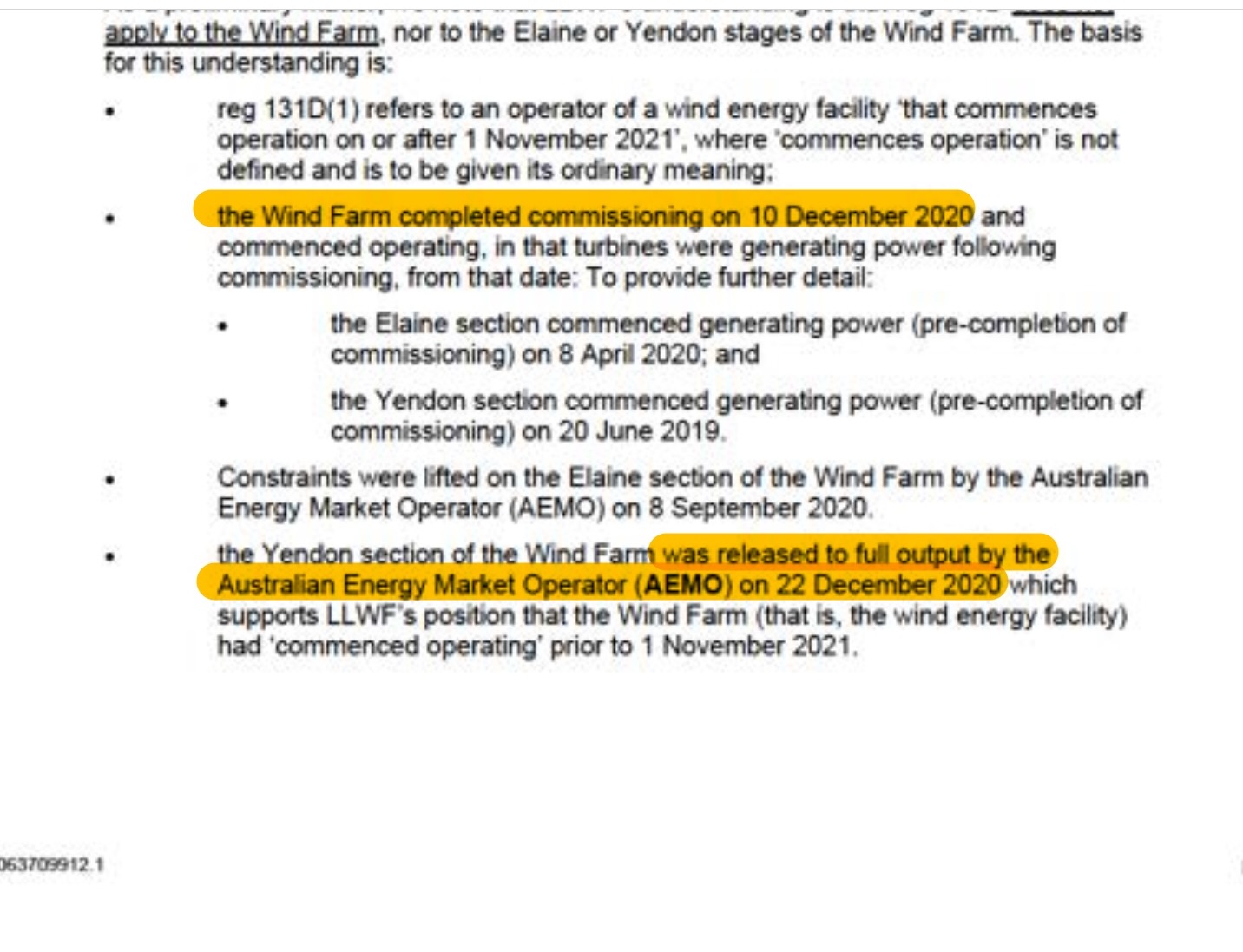

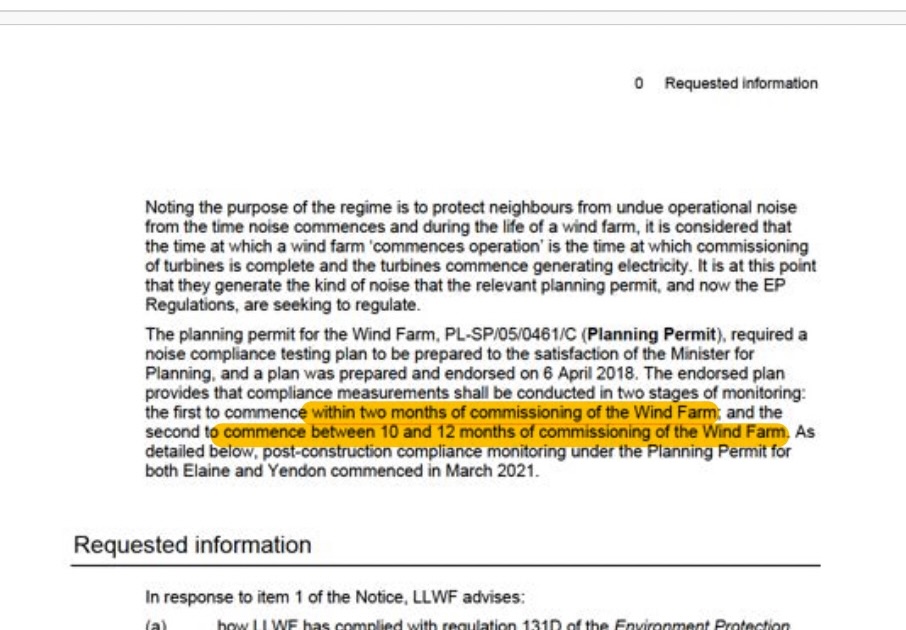

LLWF response to EPA IGN-00008382 Commissioning completed 10 December 2020; Yendon released to full output 22 December 2020. The operator expressly distinguishes completion of commissioning from earlier generation and the later full-output release.

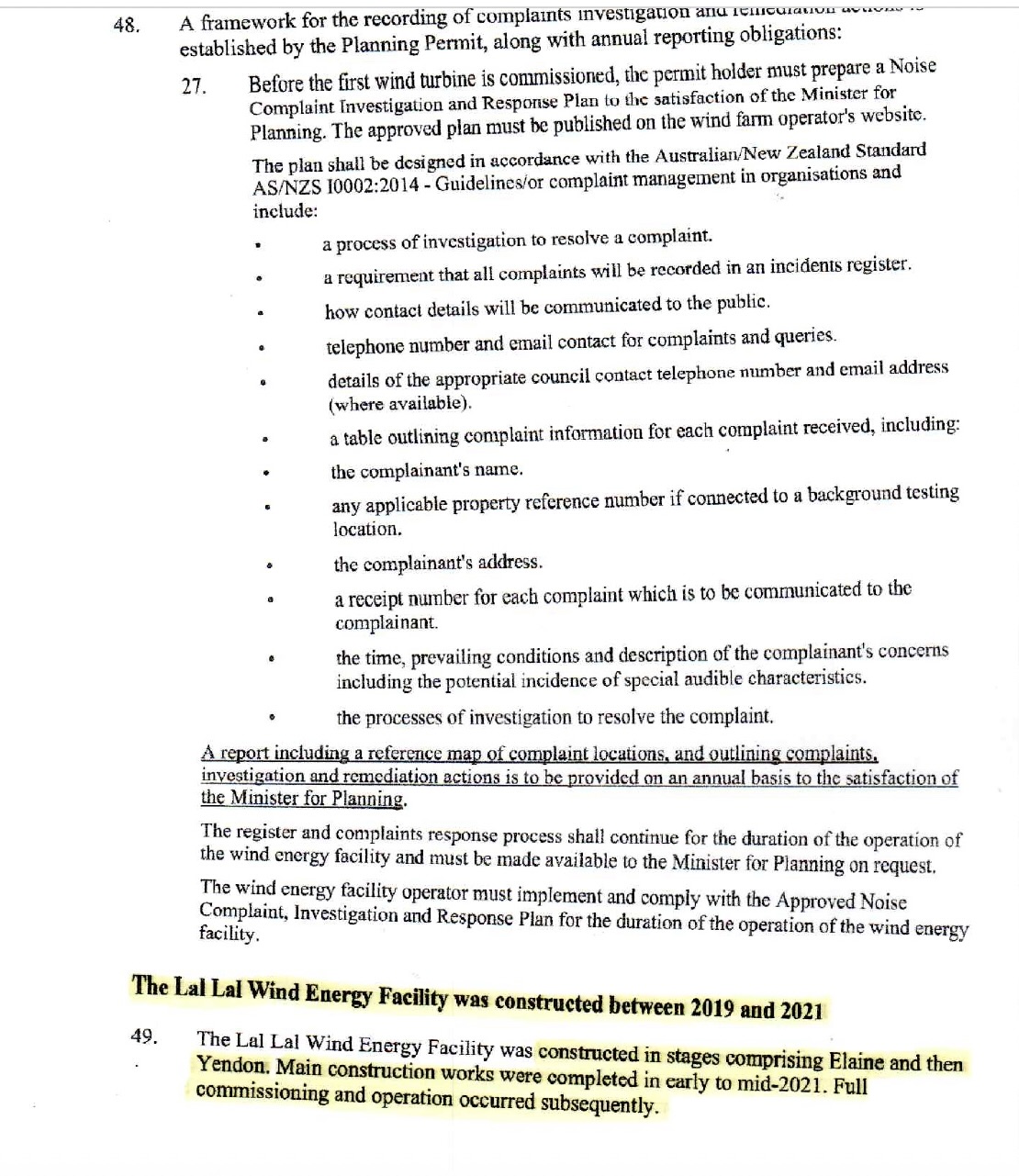

LLWF Practice Day Submissions — VCAT P775/2023 Main construction completed in early to mid-2021; “Full commissioning and operation occurred subsequently.” This is a statement in the Permit Holder's submissions, not a VCAT finding, and it describes a later commissioning/operation sequence than the 2020 IGN date.

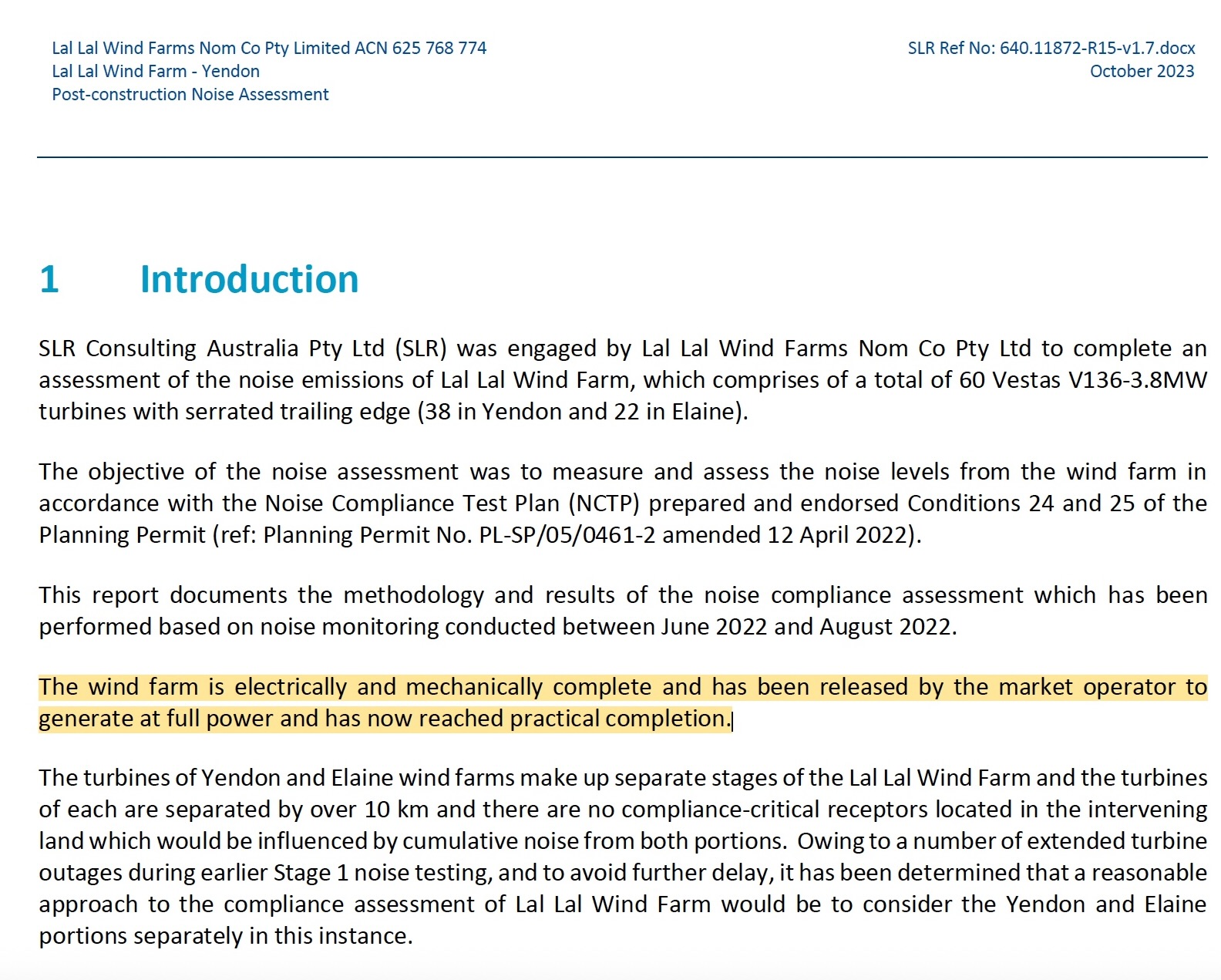

SLR Yendon report — October 2023 Wind farm described as electrically and mechanically complete, released to generate at full power and having reached practical completion. The report records project status but does not identify the date on which those milestones occurred.

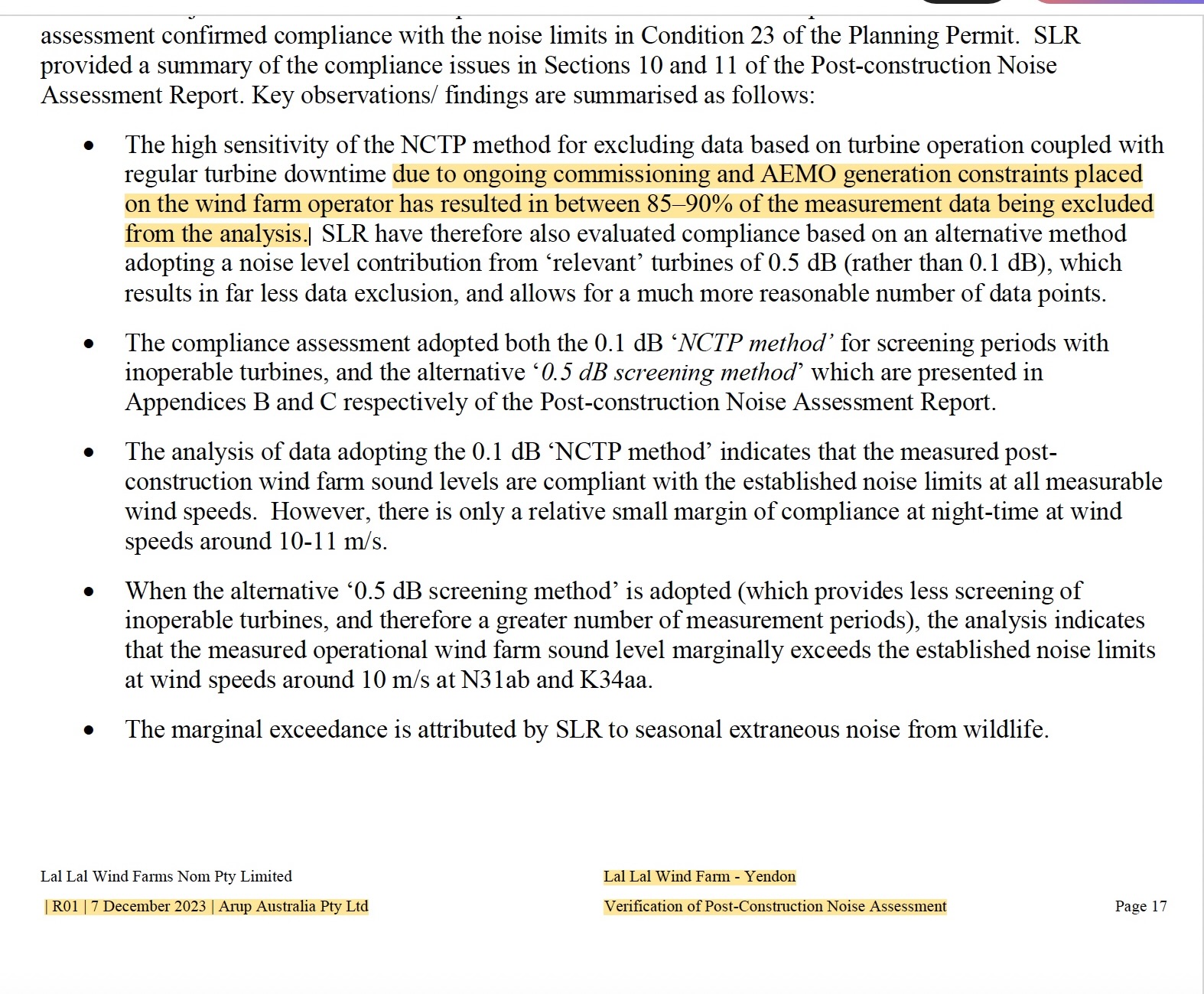

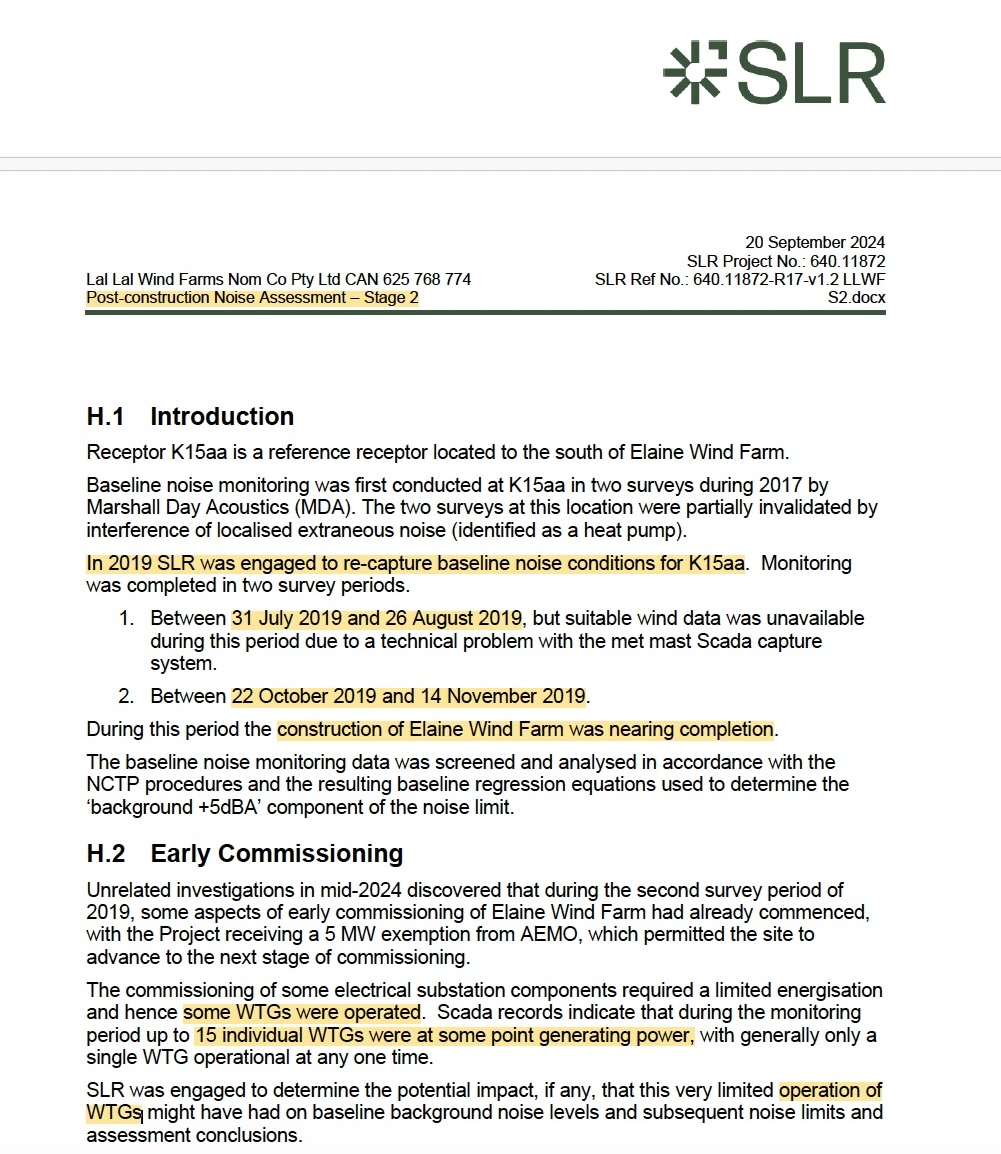

ARUP Yendon verification — 7 December 2023 Records regular turbine downtime due to “ongoing commissioning and AEMO generation constraints” as part of the explanation for 85–90% data exclusion. The wording appears in the auditor's summary of the Yendon assessment and is preserved without treating “ongoing commissioning” as automatically equivalent to the NCTP's “commissioning of the last turbine”.

Different concepts

Generation, release to full output, commissioning completion, full commissioning, practical completion and final-turbine commissioning are separately described in the disclosed record.

NCTP trigger

The endorsed NCTP does not simply use “project completion”. It requires Stage 1 and Stage 2 monitoring by reference to commissioning of the last turbine of the Lal Lal Wind Farm.

Question left by the record

Which commissioning event and date was actually used to administer the NCTP's mandatory two-month and 10–12-month monitoring windows?

Present documentary position: The records do not presently reconcile to one uniform commissioning milestone. The website therefore preserves each source, identifies the purpose for which the date or status was used, and does not silently substitute one expression for another.
Administrative reconciliation

Trustee enquiry seeking the commissioning completion record

After identifying the later operator statement that the wind farm completed commissioning on 10 December 2020 and commenced operating from that date, the Trustee asked Lal Lal Wind Farm for the commissioning certificate or equivalent commissioning-completion document for the final turbine. The enquiry expressly stated that it was made for administrative record purposes only and that no allegation was made.

Follow-up and documentary status. After no acknowledgement had been received, the Trustee sent a follow-up dated 4 March 2026 seeking confirmation that the enquiry had been received and recorded in the Enquiries and Complaints Register in accordance with the published Community Engagement Policy and Complaints and Enquiries Procedure.

See also: Commissioning Enquiry - Trustee correspondence concerning the asserted commissioning-completion date and request for documentary confirmation.

Commissioning source register

Documents supporting this page

Construction and Commissioning documentary bundle
CRG records, construction and commissioning chronology, monitoring tables and related administrative material.
Open PDF

Community Bulletin — June 2020
Public landscaping-program closure statement linked to the commissioning milestone.
Open PDF
Planning Permit PL-SP/05/0461
Conditions 12, 17 and 23–25.
Open PDF
Endorsed Noise Compliance Testing Plan
Operational limits, monitoring triggers, section 6.0 reporting and section 7.0 responsibilities.
Open PDF
Condition 17 bird and bat report request
Administrative record concerning the final-turbine commissioning date used for the second annual monitoring report.
Open PDF
FOI decision — commissioning date / Condition 12
Council FOI record concerning the date used in administering the off-site landscaping condition.
Open PDF
Commissioning enquiry record
Trustee enquiry and follow-up seeking the commissioning certificate or equivalent completion record.
Open PDF
LLWF response to EPA Information Gathering Notice IGN-00008382
Operator response dated 14 April 2025 recording commissioning completion, earlier generation dates and Yendon release to full output.
Open PDF
SLR — Yendon Stage 1 Post-construction Noise Assessment
October 2023 report recording electrical/mechanical completion, full-power release and practical completion.
Open PDF
ARUP — Yendon Verification of Post-Construction Noise Assessment
R01 dated 7 December 2023, including the auditor's summary of data exclusion, ongoing commissioning and AEMO generation constraints.
Open PDF
VCAT P775/2023 — LLWF Practice Day Submissions
Permit Holder submissions stating construction occurred between 2019 and 2021 and that full commissioning and operation occurred subsequently.
Open PDF
How to read the date record

The disclosed sources do not use one uniform date

The present record includes public material implying final-turbine commissioning on 18–19 November 2019; the operator's later statement that commissioning was completed on 10 December 2020 and Yendon was released to full output on 22 December 2020; the Permit Holder's VCAT submission that main construction continued into early to mid-2021 and full commissioning and operation occurred subsequently; SLR's later practical-completion description; and ARUP's reference to ongoing commissioning in the Yendon assessment. The repository preserves each source and the status concept it uses rather than treating these expressions as automatically synonymous.
